Implementation Stages Data Center
Transfer of Equipment to Temporary Location
-
Relocation of existing equipment to a temporary space for execution operations.
Initial demolition
-
Removal and demolition of the existing floor, ceiling, walls, and doors to prepare the environment.

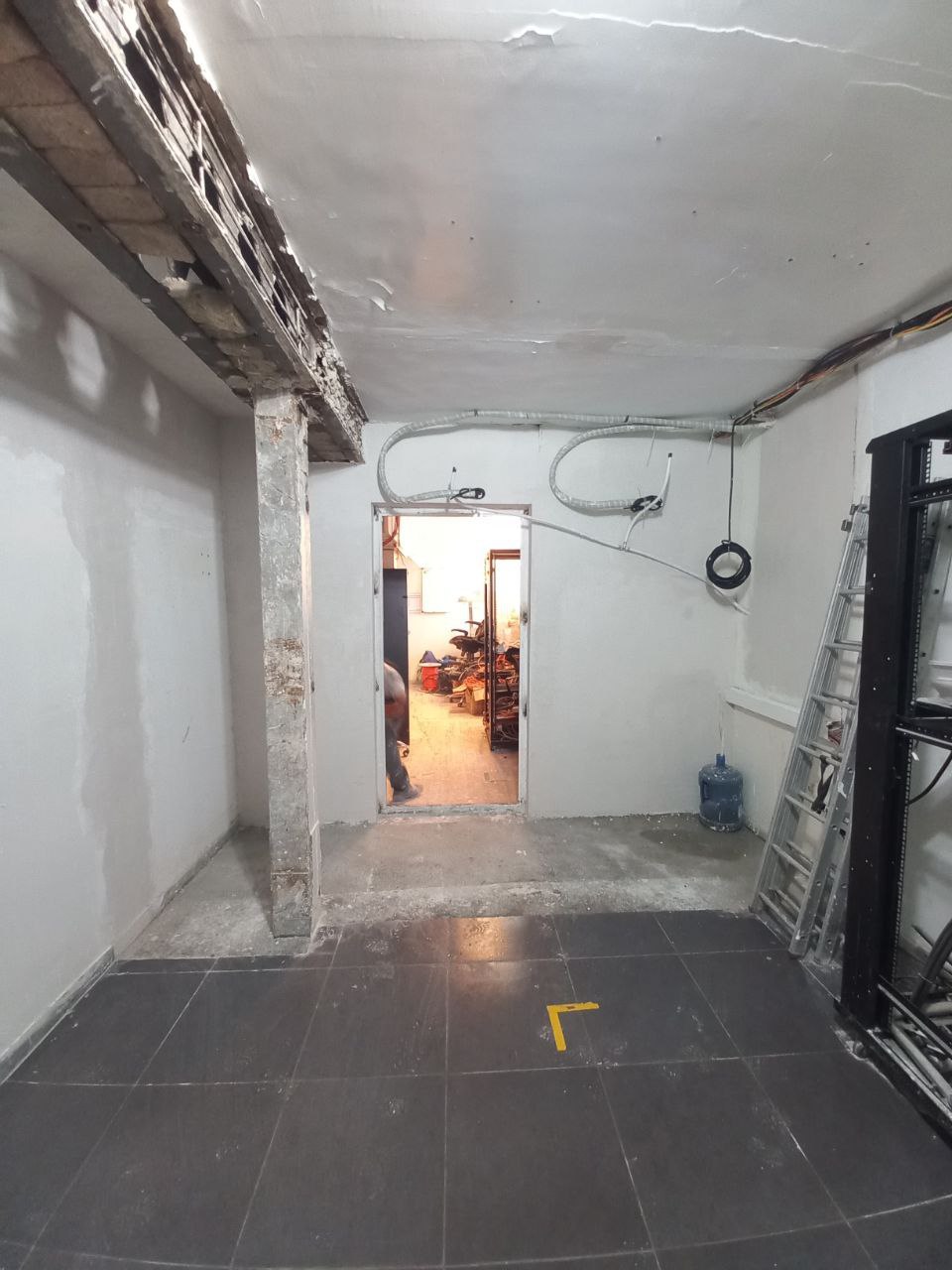

Construction of physical infrastructure
-

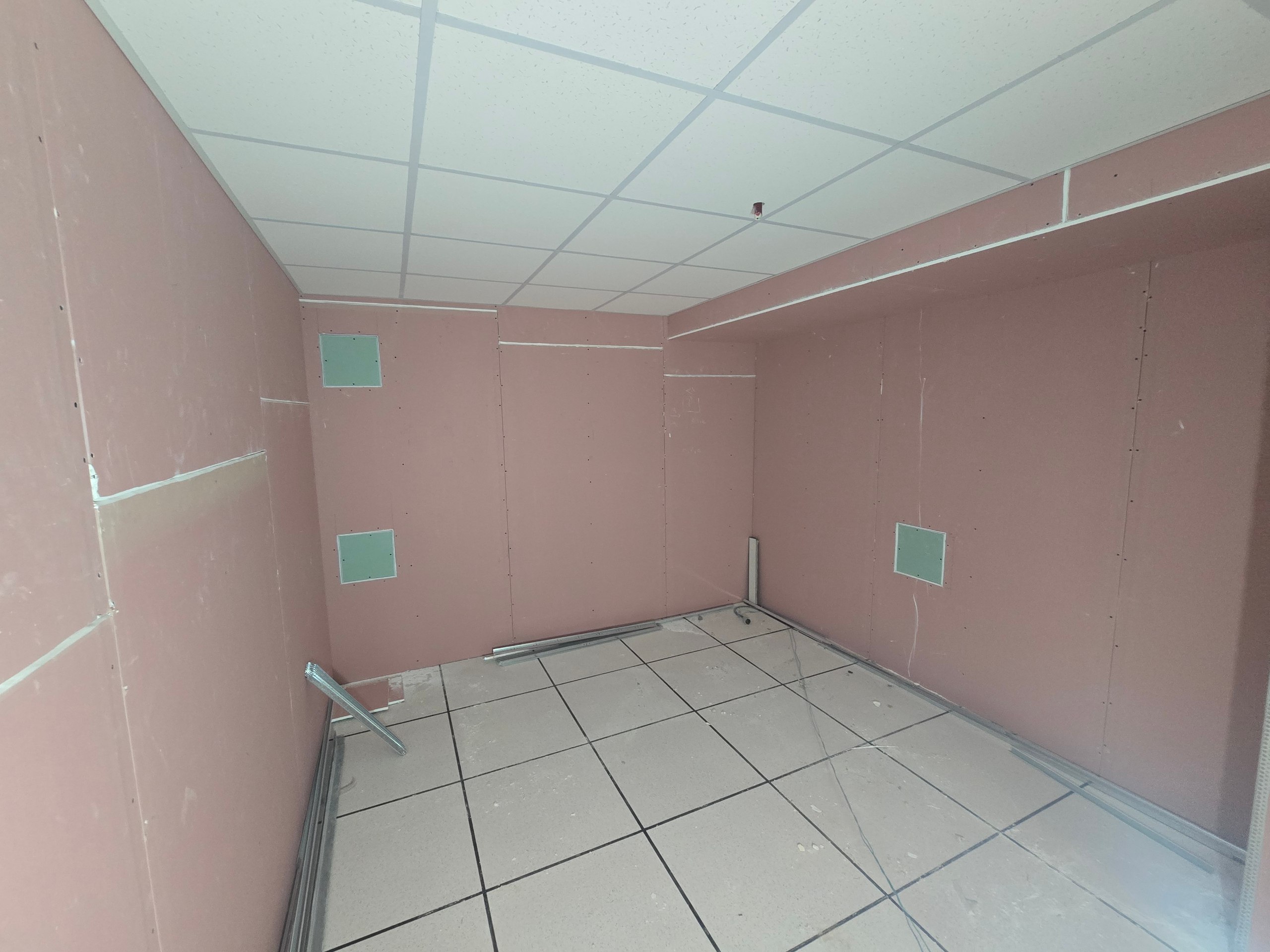

Installation of raised floor and false ceiling in compliance with data center standards.
-
Construction of fire-resistant (fireproof) walls
-
Creation of a trap basin with epoxy coating to prevent the infiltration of water and contaminants.

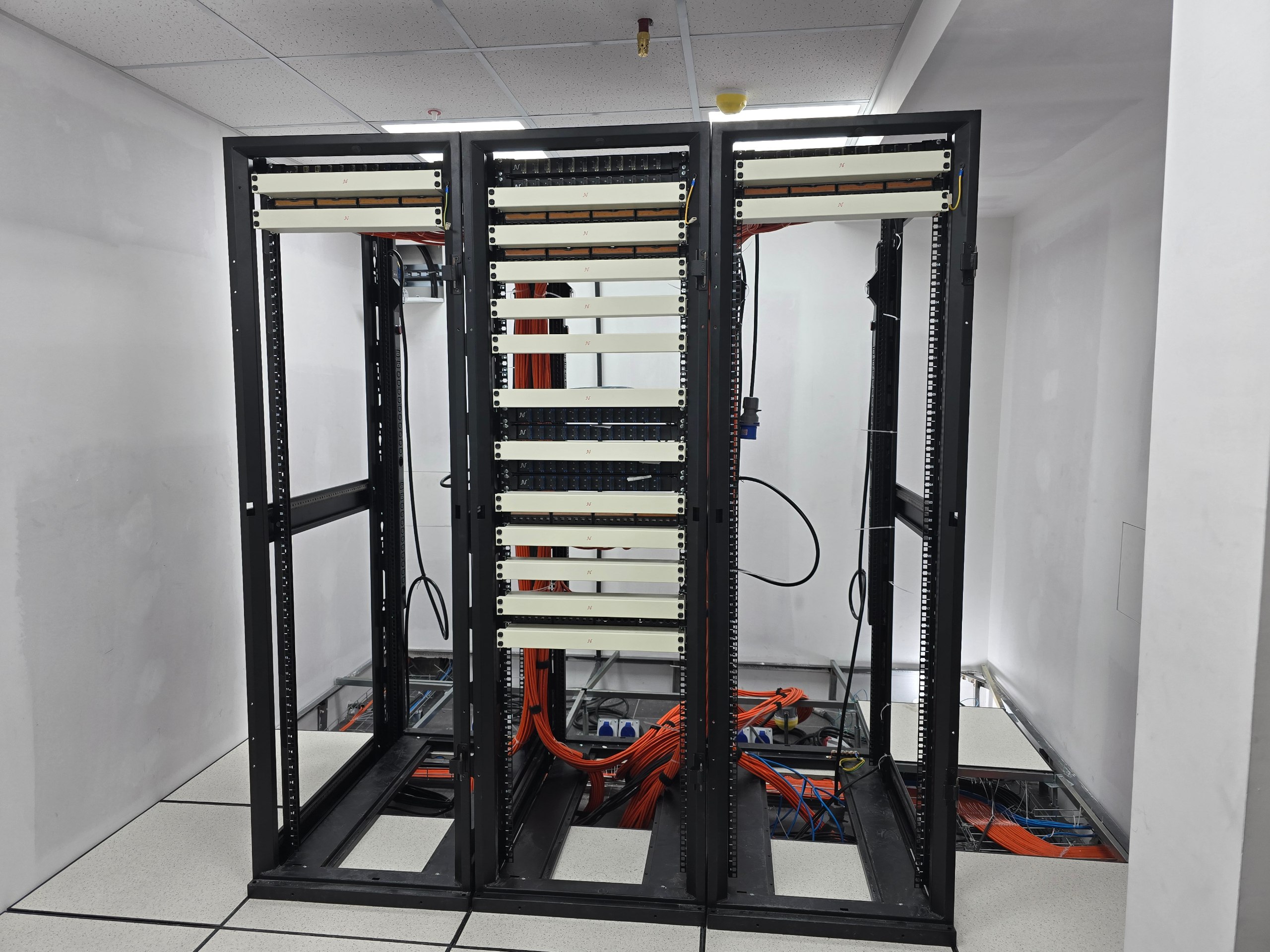

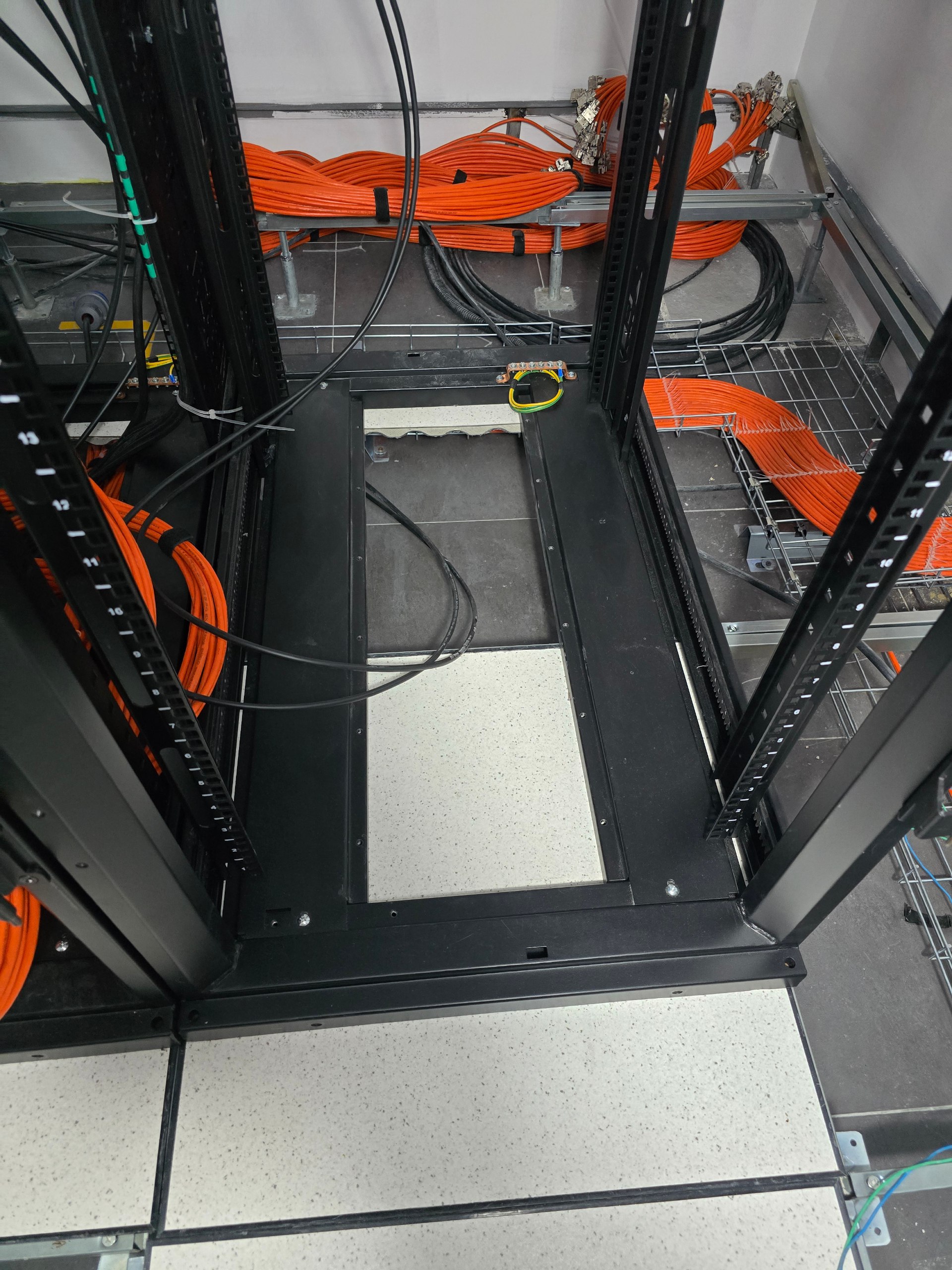

Installation of rack equipment and cabling.
-
Installation of racks according to the layout plan of hot and cold aisles.
-

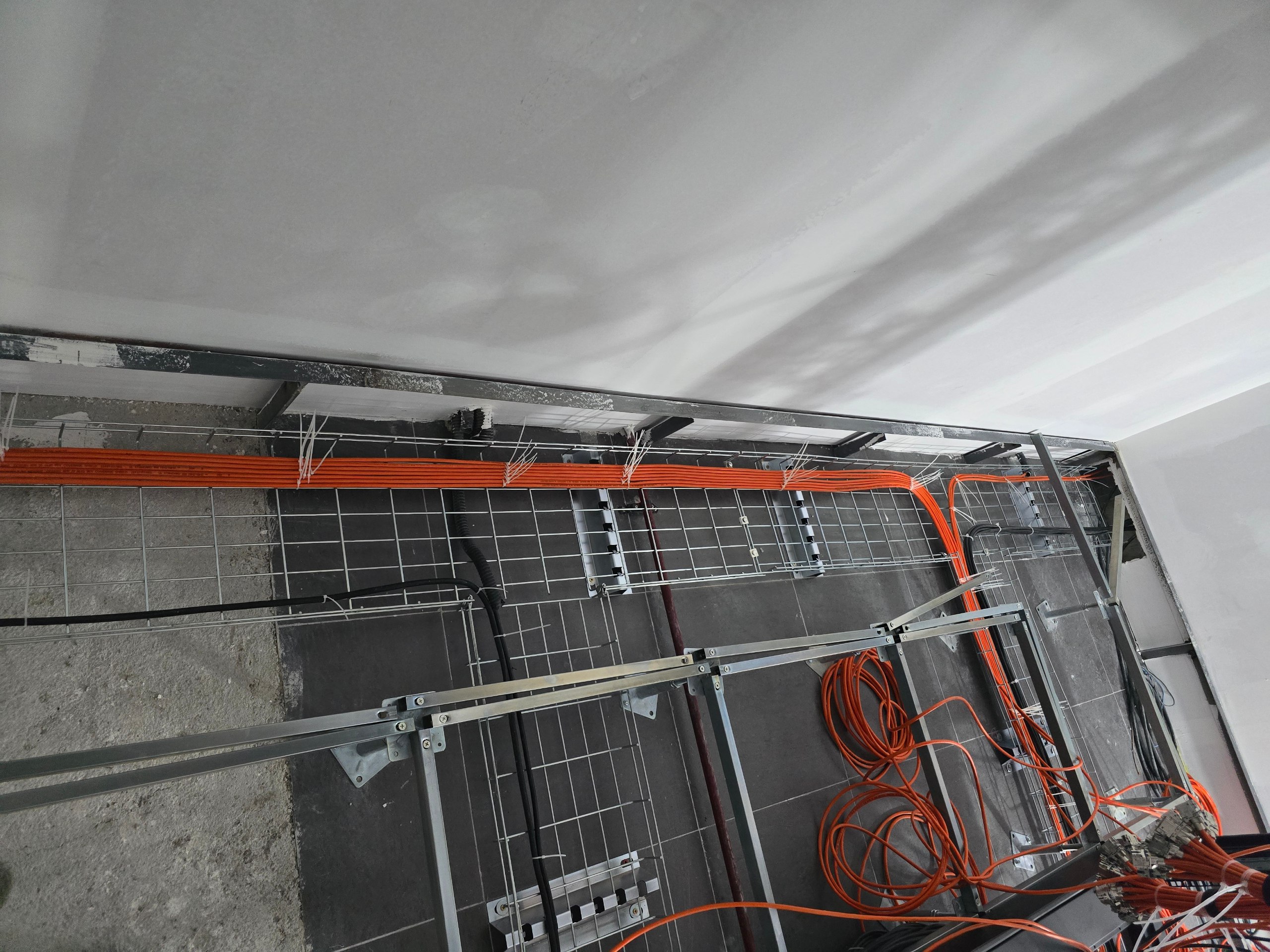

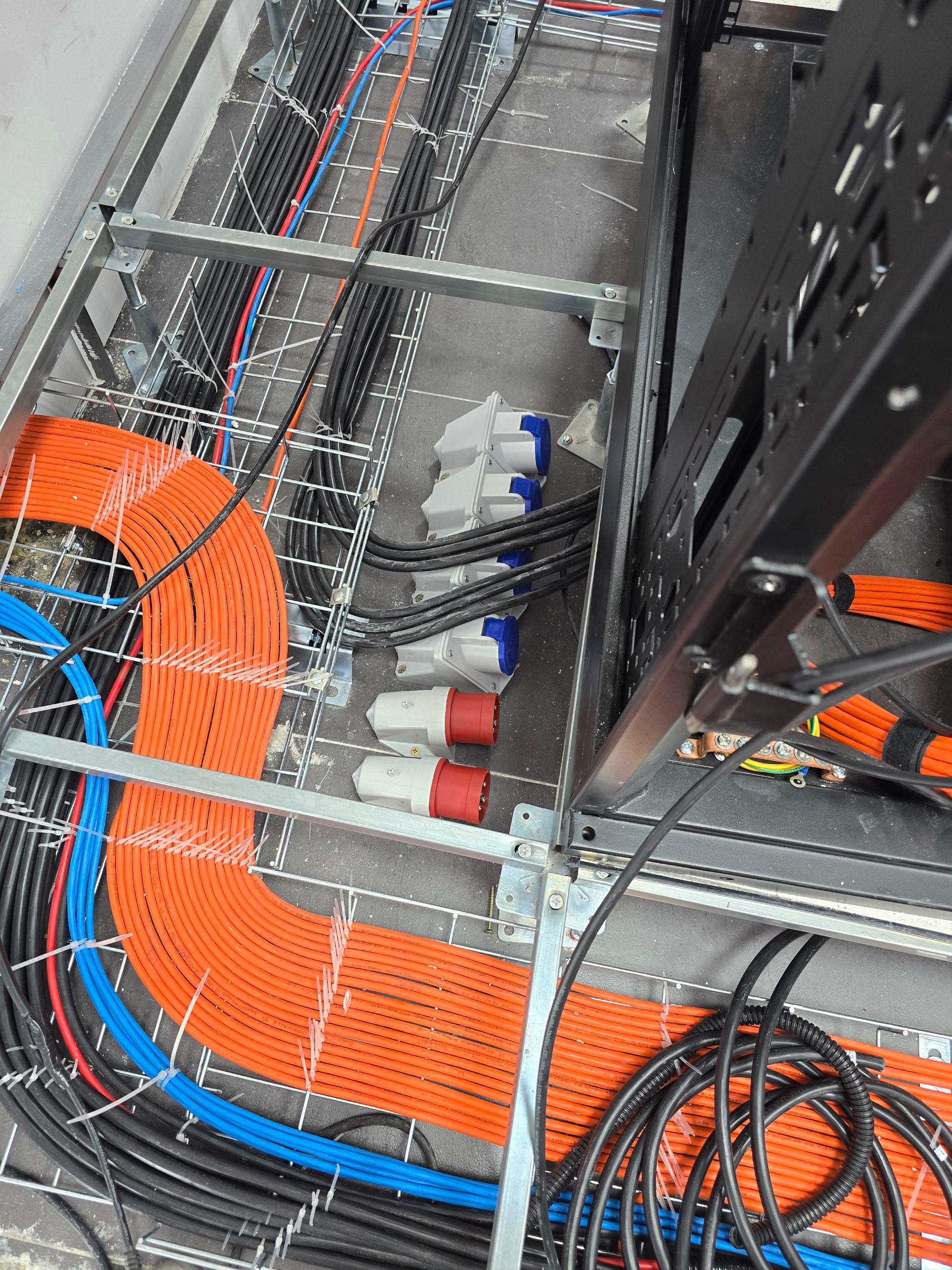

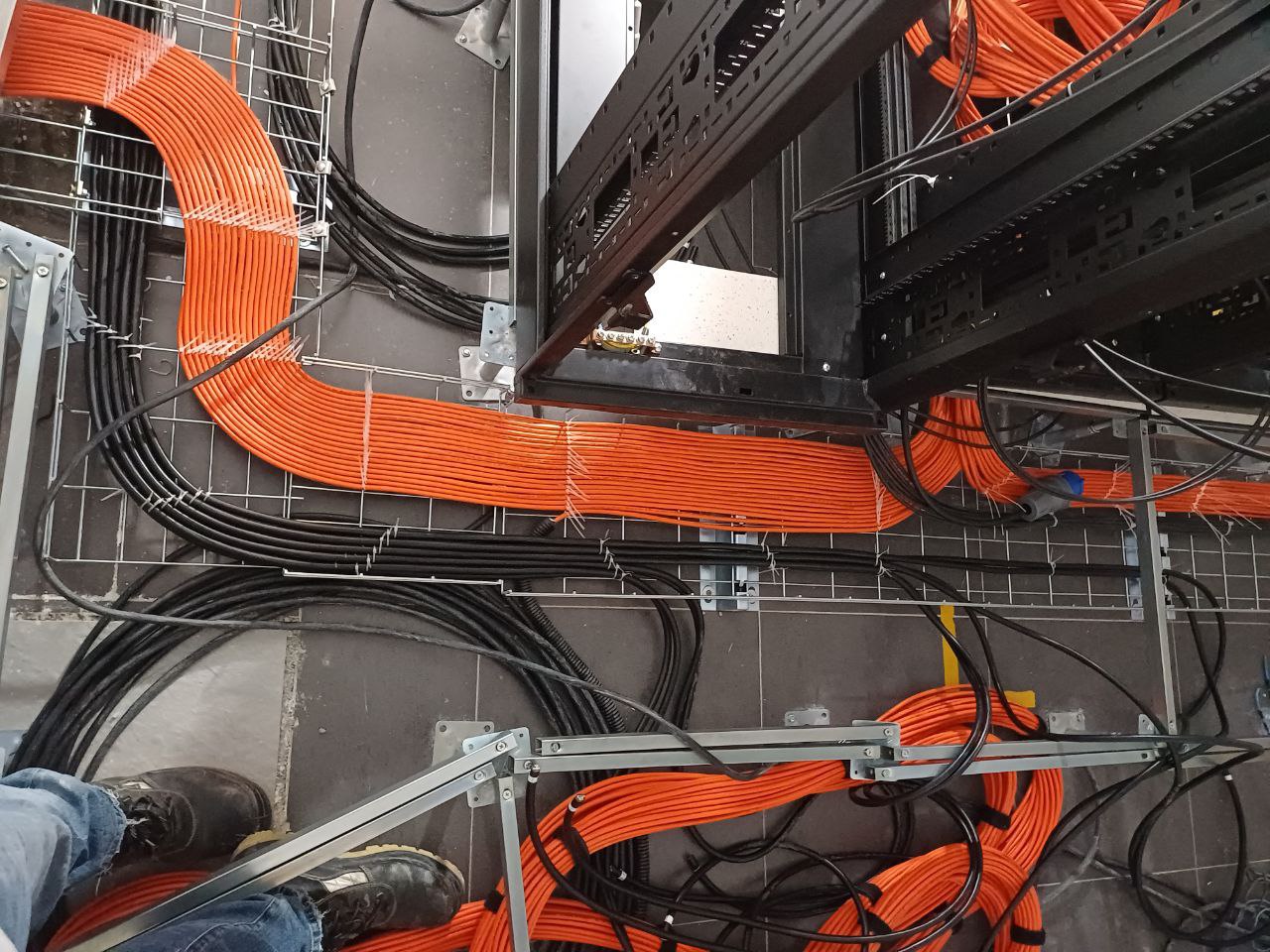

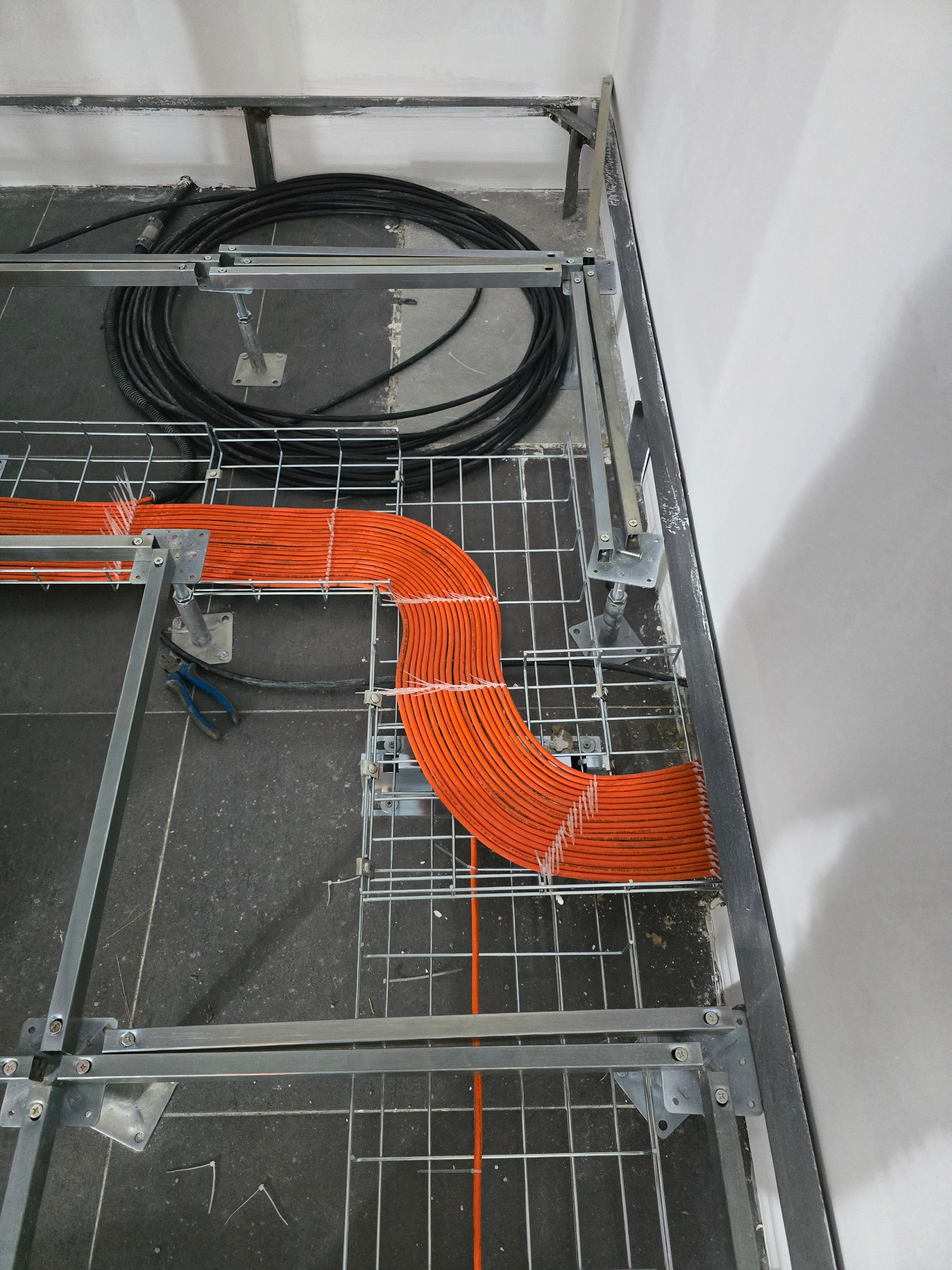

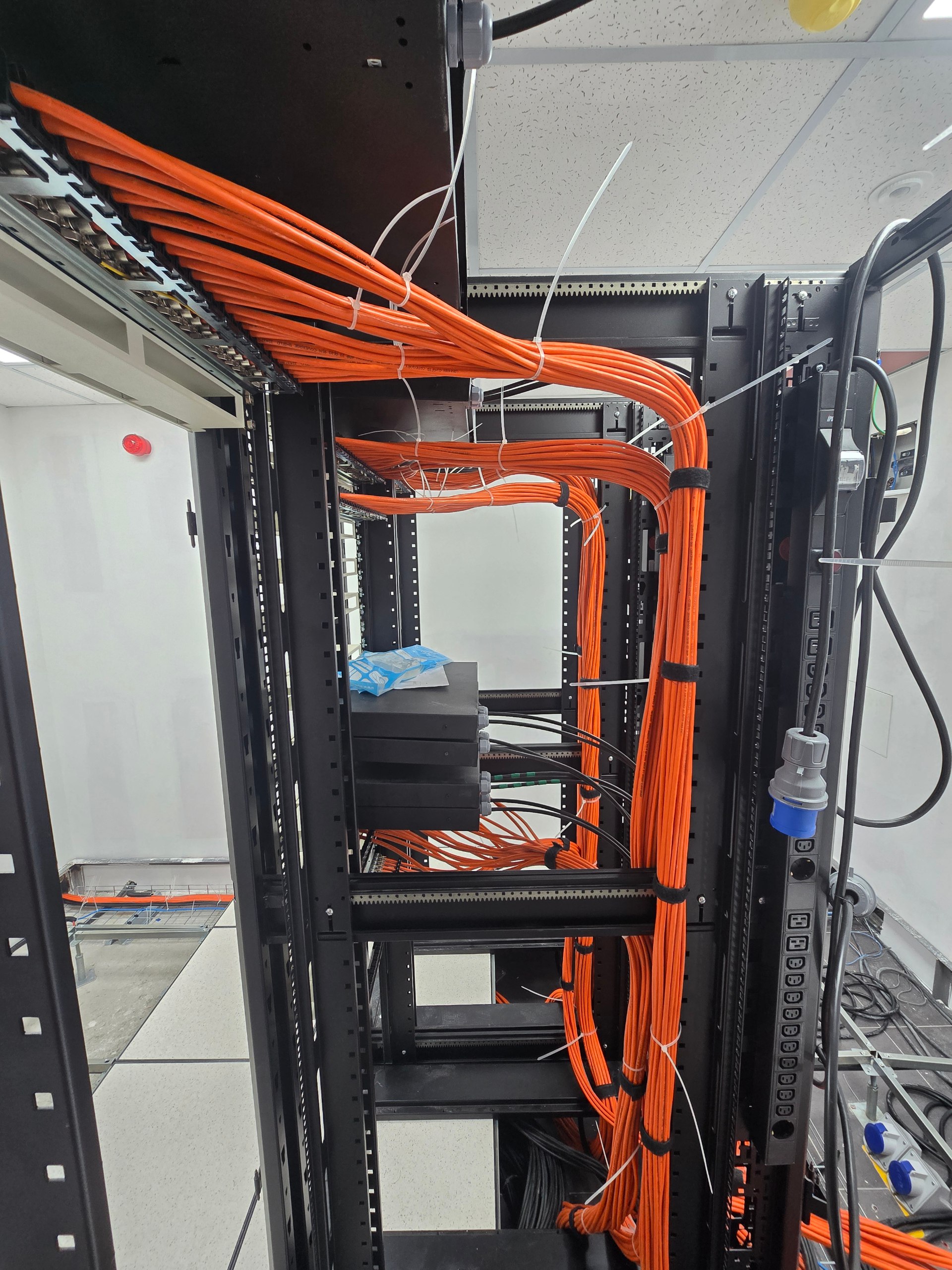

Cable arrangement through raised flooring and inside racks (structured cabling).

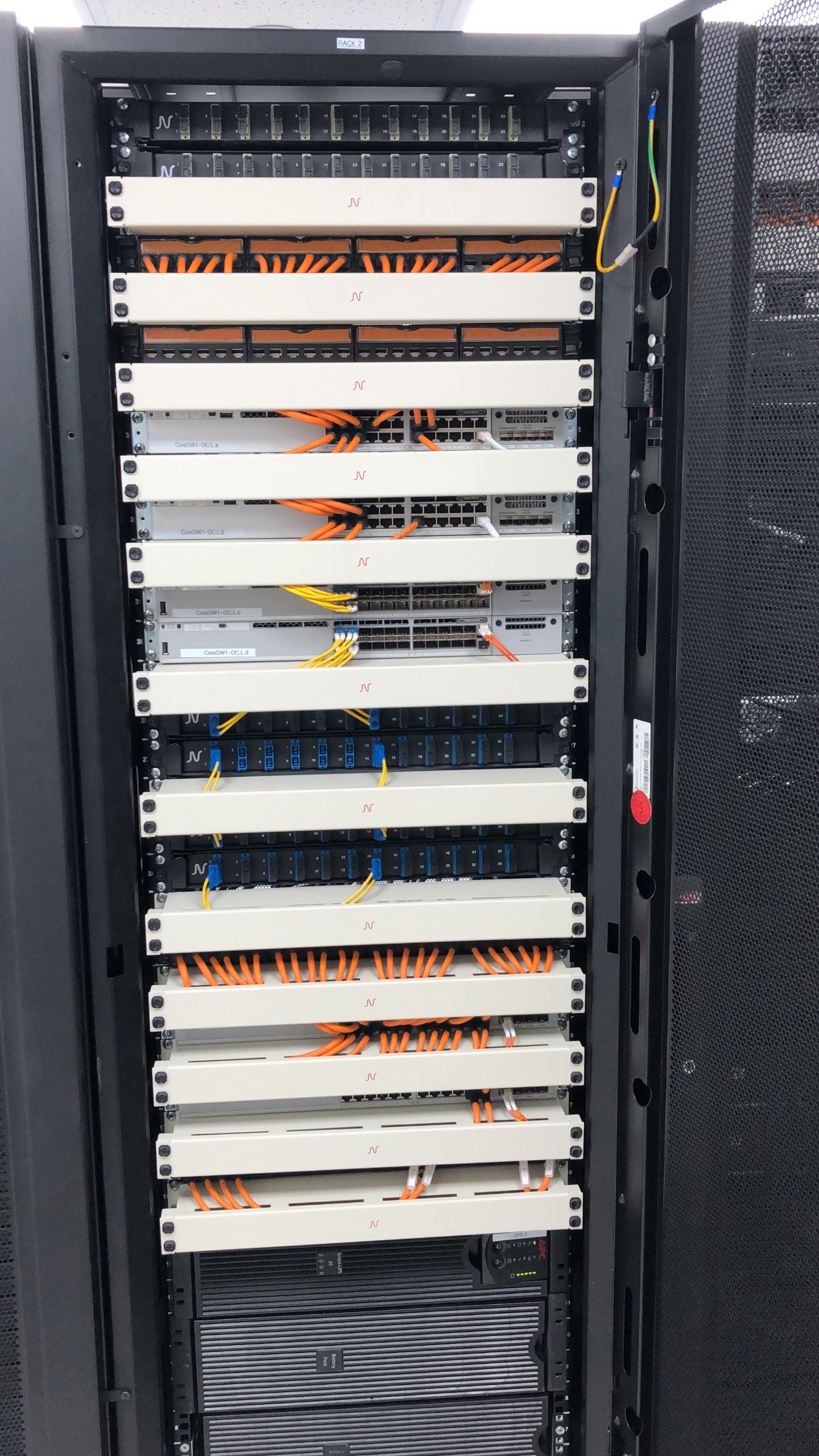

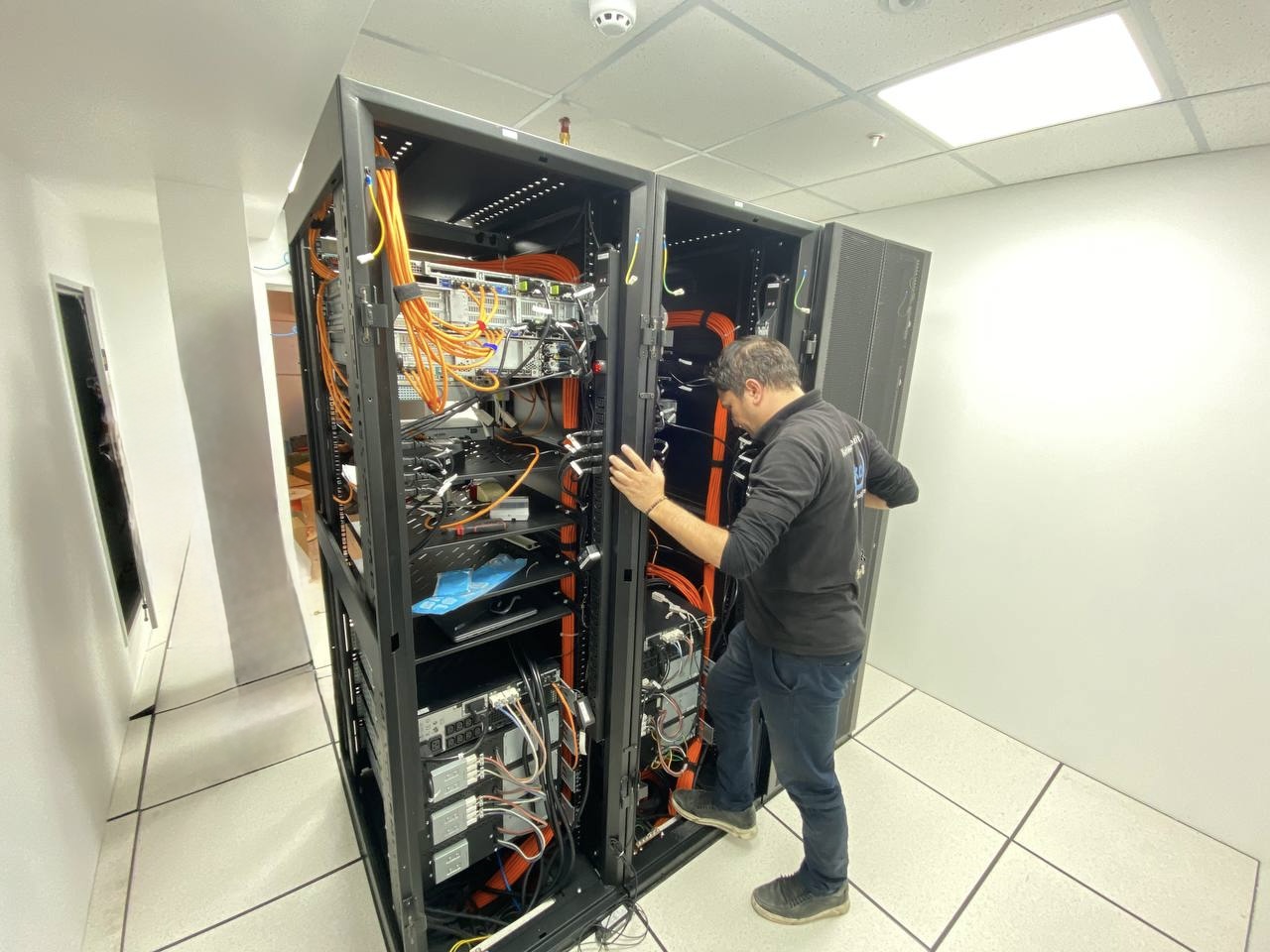

Installation of active equipment
-
Installation and arrangement of active network equipment inside the racks.
Installation of active equipment
-
Full testing of security, surveillance, fire detection, and fire suppression systems.
-
Network equipment functionality test (active and passive) to ensure correct installation and proper operation.
